Report on Valet Deck Project May 26, 2015 2 of 2

aquarius51Valet Deck Project:  Schedule and Logistical Plan    May 26, 2015

2 of 2

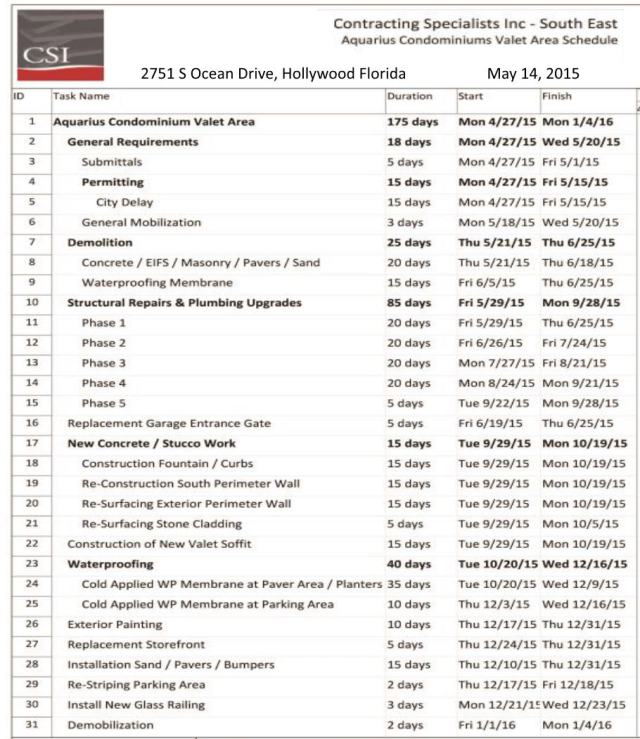

2015 05 14 Valet Deck Project Schedule

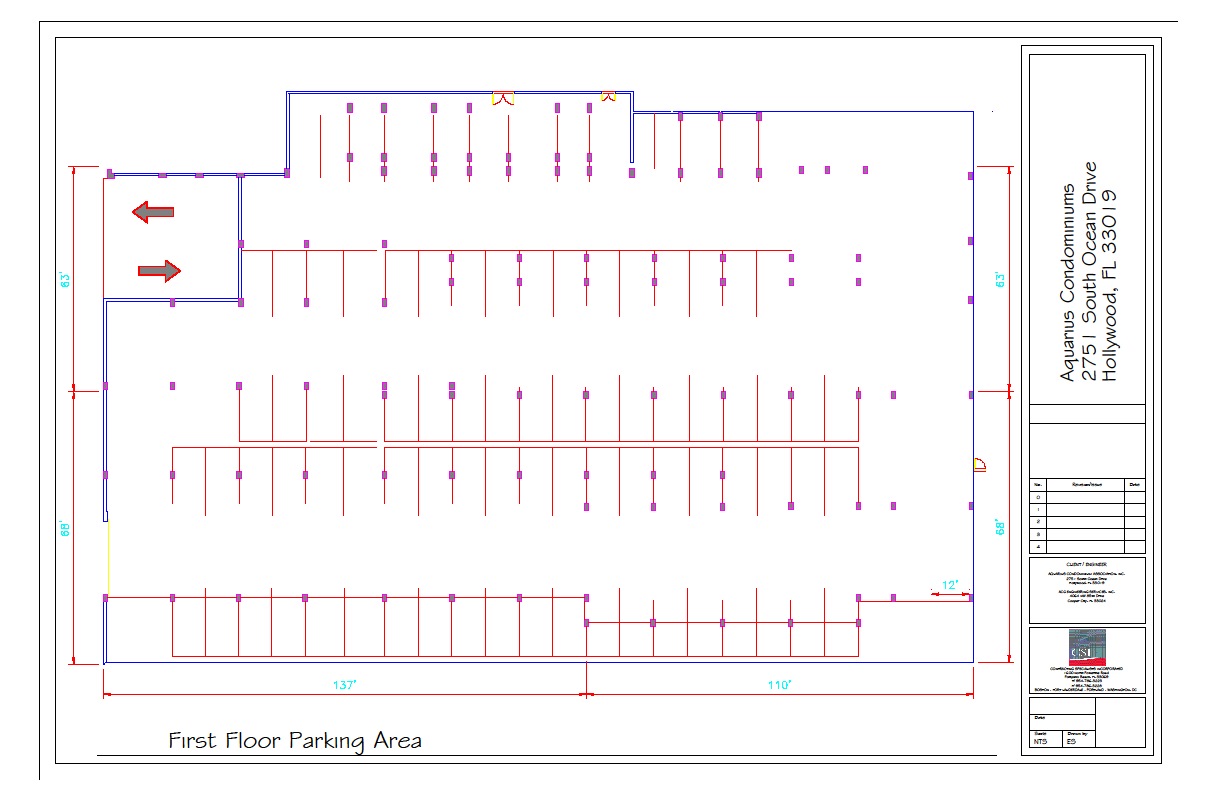

2015 04 24 First Floor Park Area 1

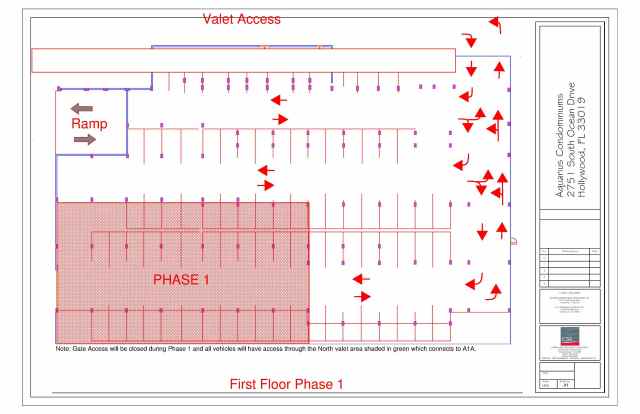

2015 04 24  phase 1

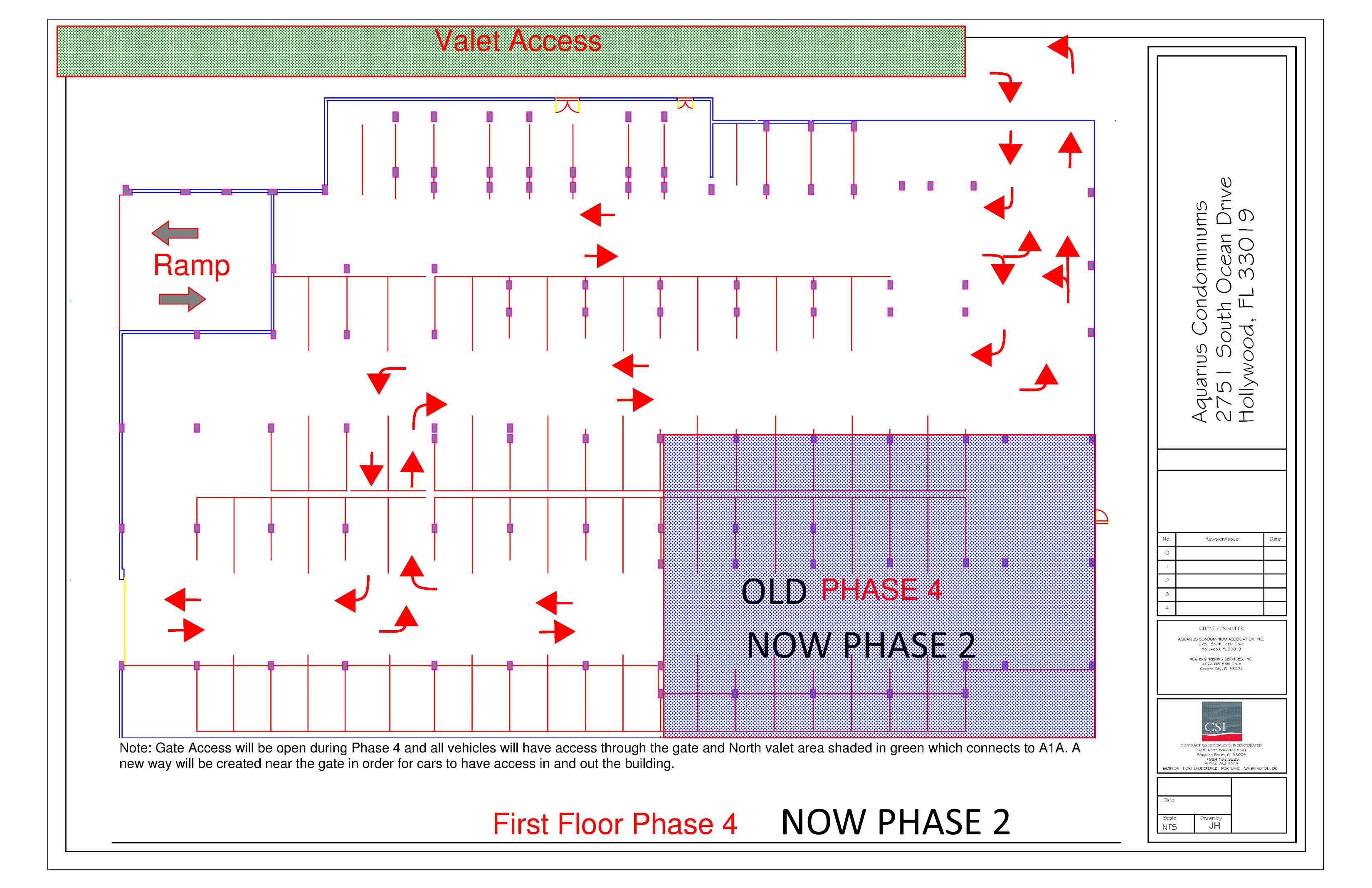

2015 04 24 page3 old phase 4 now 2

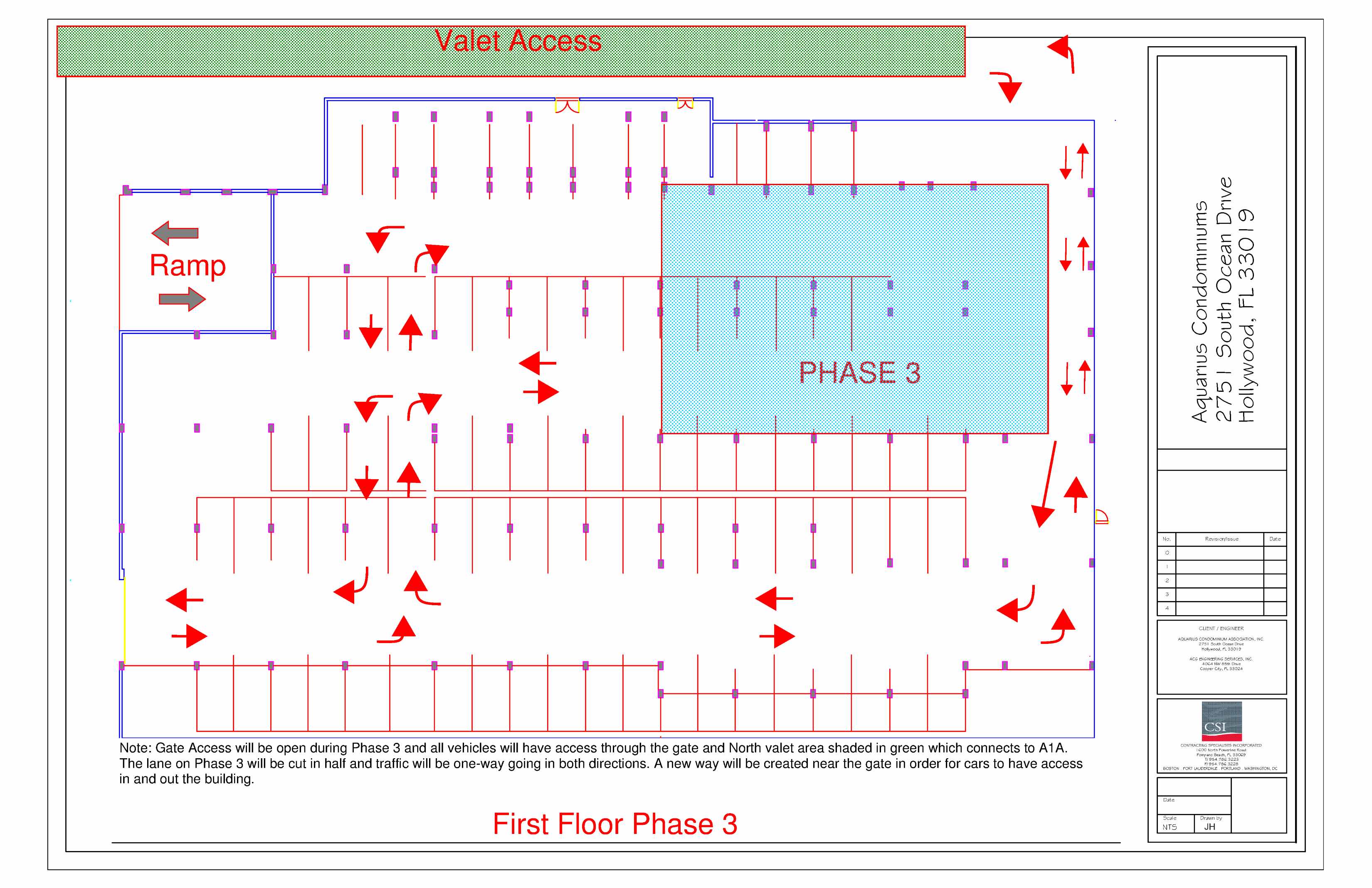

2015 04 24 page 5 Phase 3

2015 04 24 page4 old phase 2 now 4

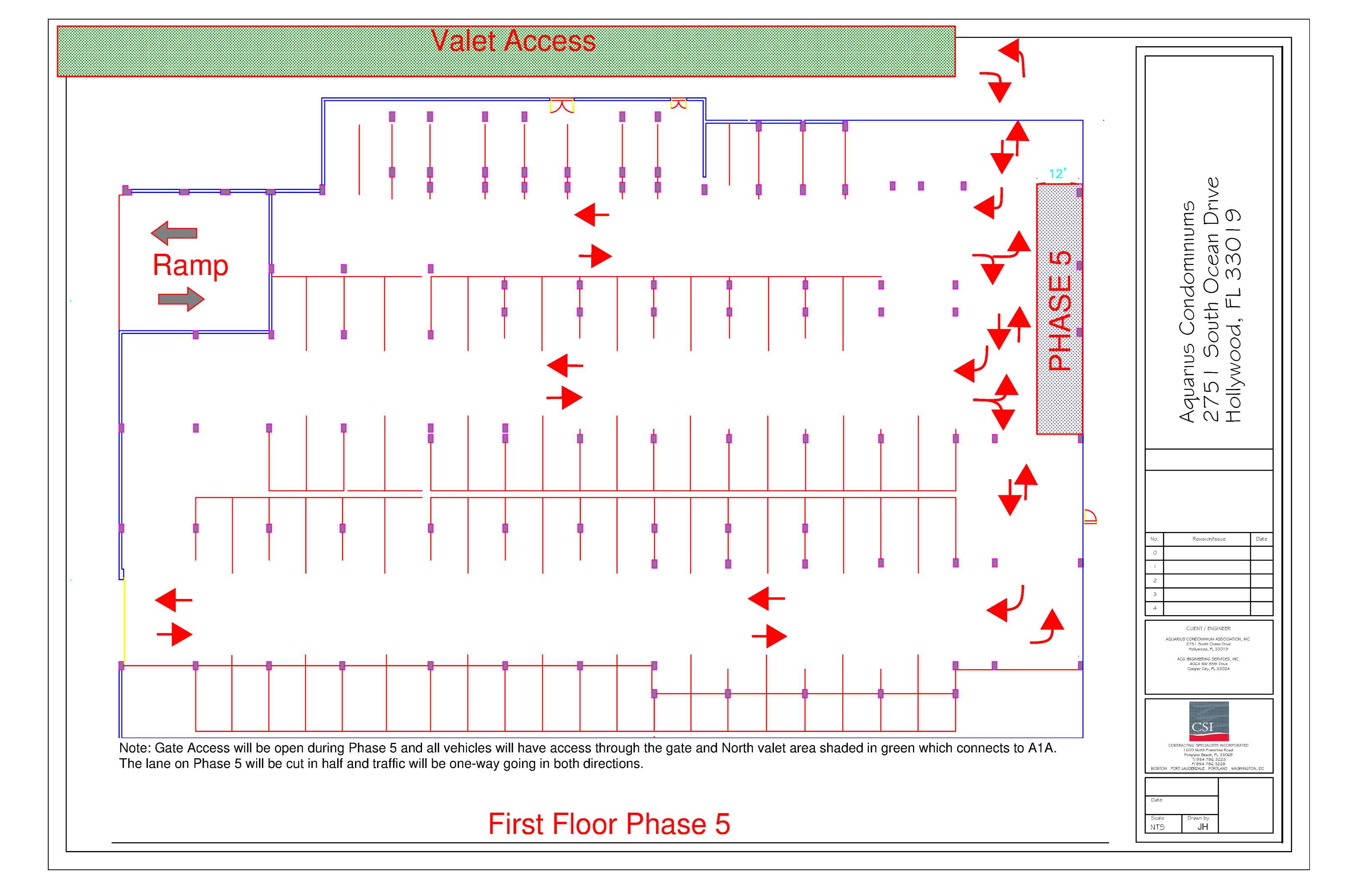

2015 04 24 page 6 phase 5

.o0o.o0o.o0o.

About Cecilio Augusto Berndsen

Information Technology, Management, Project Management and Public Administration are areas I am familiar with. I am also interested in photography, wine, sailing, politics, economics, and economic development.
This entry was posted in Board of Directors, Construction & 40 Year Inspection, Management Office and tagged , , , , , , , , , , , , , , , . Bookmark the permalink.

Leave a Reply

Fill in your details below or click an icon to log in:

WordPress.com Logo

You are commenting using your WordPress.com account. Log Out /  Change )

Facebook photo

You are commenting using your Facebook account. Log Out /  Change )

Connecting to %s
