Aquarius East Pool Deck Construction Schedule Rev.: 2017/11/01

Aquarius East Pool Deck Construction Schedule Rev.: 2017/11/01

40 Year Re-Certification Exercise

Follow the construction progress with the periodic revised schedules.

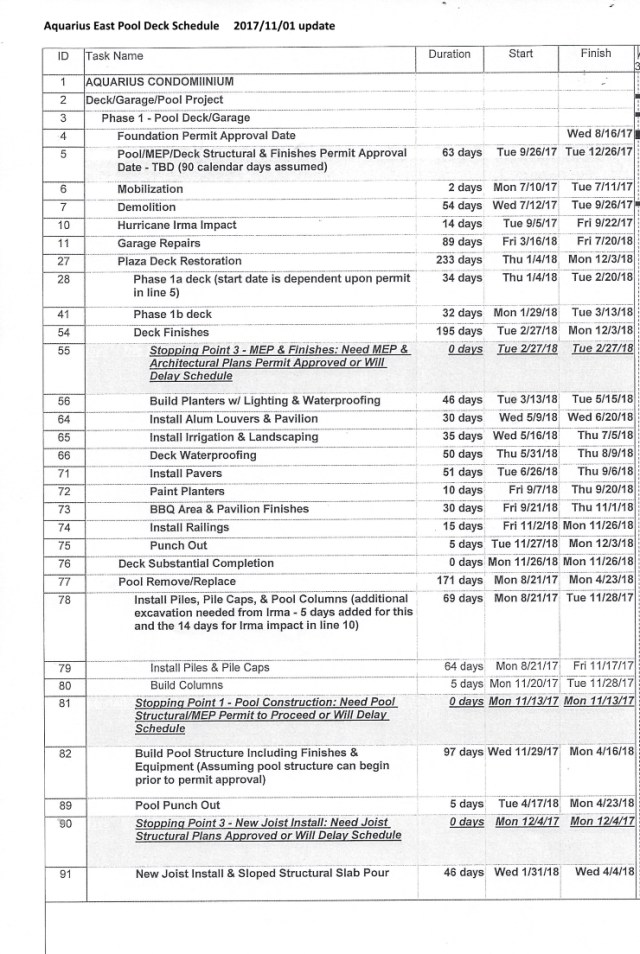

Printer friendly file format of the East Pool Deck Schedule   2017/11/01        2017 11 01 E Deck Schedule S
