Aquarius 40 Year Re-Certification – Pre-Construction Phase Schedule – Hillman Engineering

LOGO BLUEAquarius 40 Year Re-Certification – Pre-Construction Phase Working Schedule

 Hillman Engineering

Pre-Construction Evaluation and subsequent sub-phases to be completed from June 29, 2016 to April 18, 2016.

This is work is subject of the Construction Committee discussions every Thursday. All are invited to participate and follow pari passu the progress of the 40 Year Re-Certification exercise. After completion of this “Pre-Construction Phase” there will be a “Construction Phase.” This second phase could last from 12 to 18 months into 2018.

Broward County has prepared detailed guidelines for the 40 Year Re-Certification program. This safety exercise has the main objective to assure the structural integrity and safety of large buildings. The Broward Count guidelines and additional relevant literature are available HERE  – the link opens in a new tab.

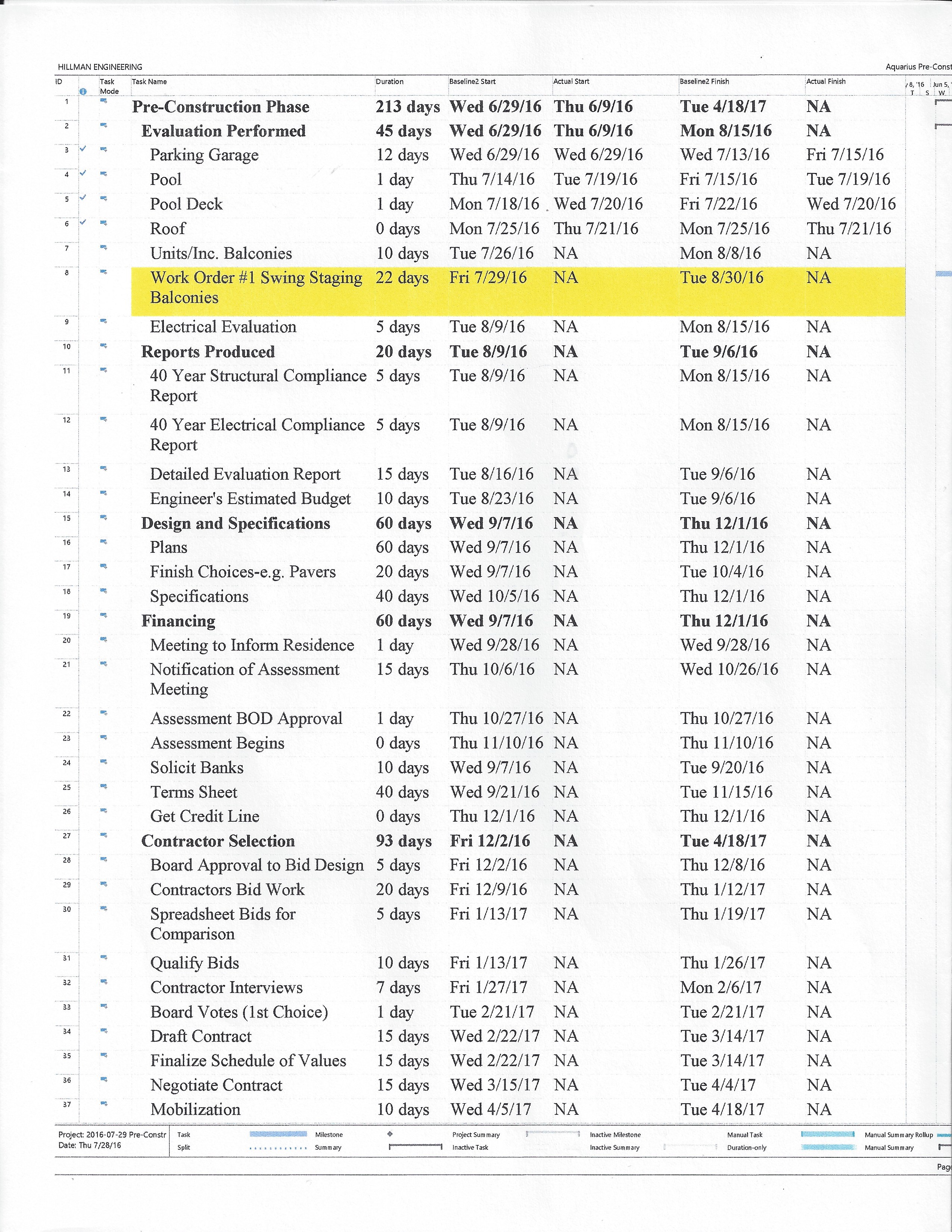

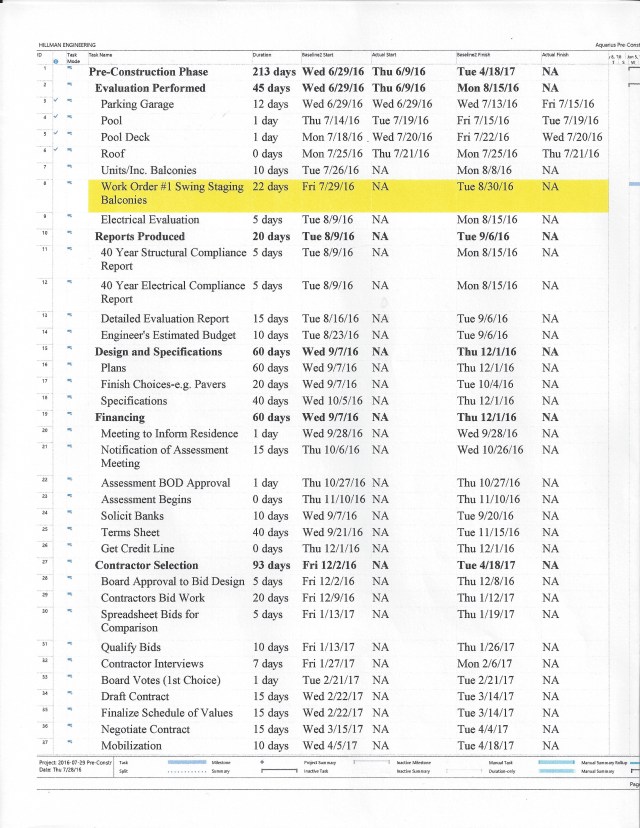

2016 06 29 Hillman Schedule

.o0o.

About Cecilio Augusto Berndsen

Information Technology, Management, Project Management and Public Administration are areas I am familiar with. I am also interested in photography, wine, sailing, politics, economics, and economic development.
This entry was posted in Construction & 40 Year Inspection and tagged , , , , , , . Bookmark the permalink.

Leave a Reply

Fill in your details below or click an icon to log in:

WordPress.com Logo

You are commenting using your WordPress.com account. Log Out /  Change )

Facebook photo

You are commenting using your Facebook account. Log Out /  Change )

Connecting to %s
